[ Website ]
How long does it take to design a website? Most of the answer is waiting
A typical business website takes 6 to 10 weeks. Elapsed time is studio work plus waiting for feedback and content, and in a simple model, halving review turnaround saves more than a studio working 20 percent faster. Plans also run optimistic, so ask for actual past timelines, and start domain and DNS tasks early.
By LAIN9 min read

For a typical business website, LAIN plans 6 to 10 weeks from the first conversation to launch. One-page sites move faster, and larger builds with a CMS, e-commerce or integrations take longer. That answer is honest but incomplete, because the interesting question is what separates 6 from 10, and why a number quoted by another studio can look so different. The short version: elapsed time is work plus waiting, and the waiting is often the bigger lever.
Why quoted timelines disagree
Searching the question returns ranges from "under a week" to "six months". They are not contradicting each other. They are counting different things.
- Where the clock starts. The signed contract, the kick-off call, or the day content is ready?
- Where it stops. Design approved, build finished, live, or search rankings settled?
- What a "page" is. Unique layouts, or every URL?
Shopify's guide to building a website gives "one week to five months" overall, and lists stage durations: 1 to 2 weeks for CMS and hosting, 1 to 3 for goals and information architecture, 1 to 2 for low fidelity wireframes, 2 to 3 for high fidelity, 4 to 10 for development, 4 to 6 for marketing preparation and 3 to 5 days for launch checks. Run back to back, those stages add up to 13 to 26 weeks. So they obviously overlap, or are optional. Other agency and vendor guides we found give 4 to 12 weeks for a small business site. None of these are measured datasets. They are planning ranges, and you should ask any studio which clock it is using.
Elapsed time is work plus waiting
Here is a deliberately simple model. It is not a LAIN schedule. Assume 30 working days of studio effort, including the time to apply feedback, and four review gates (direction, design, build, final). At each gate the client takes T working days to respond and there are R rounds. Elapsed working days = 30 + 4 × R × T.
| Review turnaround (T) | Rounds per gate (R) | Elapsed days | Weeks | Share spent waiting |
|---|---|---|---|---|
| 1 day | 1 | 34 | 6.8 | 12 percent |
| 2 days | 2 | 46 | 9.2 | 35 percent |
| 3 days | 2 | 54 | 10.8 | 44 percent |
| 5 days | 2 | 70 | 14.0 | 57 percent |

Two comparisons show where the leverage is. A studio that works 20 percent faster (30 days becomes 24) saves 6 days at T = 3, R = 2. Cutting turnaround from 4 days to 2 at R = 2 saves 16. One extra day of delay at every gate costs 8 working days, about a week and a half. If content arrives 10 working days after the build needs it, the 54-day plan becomes 64.
This is the flow argument associated with Donald Reinertsen: in product development, queues cost more than idle people, and by Little's law the wait grows with the length of the queue however efficient the team is. A client review is a queue too. Their calendar is the one thing the studio cannot speed up, so the useful commitments are dates, not enthusiasm: who reviews, by which day, and who decides when reviewers disagree.
Count templates, not pages
Scope is the second lever, and "number of pages" is a weak way to measure it. A twenty page site on three shared layouts is a small job. A site of eight pages where every one has its own layout is eight designs, eight builds and eight rounds of testing. Estimating guides agree: list the unique templates and custom components first, then the integrations, which one guide calls the biggest surprise in most projects.
A site like LAGO, designed as three full pages (Home, Studio and Services), is three layouts before any further page exists. The sitemap planning guide shows how to separate templates from content entries.
| If the site has | It adds time to | Because |
|---|---|---|
| A blog or case studies in a CMS | Design and build | A few templates plus a content structure to plan and fill |
| E-commerce, bookings, memberships | Build and testing | Each flow needs design, build, third-party setup and test cases |
| A second language | Content, design | Translated text is usually longer. IBM's guidelines, quoted by the W3C, give 130 to 300 percent of the English length depending on string length |
| Content not yet written | Everything after design | Layouts that depend on real text must wait for it. See the copywriting guide |
Plans are optimistic: use the outside view
In 1994 Buehler, Griffin and Ross phoned 37 honours students at a Canadian university and asked when they would hand in their theses. Among the 33 who finished in time for the analysis, the average best estimate was 33.9 days and the average actual time was 55.5 days. Only 29.7 percent finished within their own best guess. When asked for the case where everything went as poorly as it possibly could, the average was 48.6 days and only 48.7 percent finished by then. The predictions were still useful: they correlated with actual times at r = .77. People ranked the work correctly and underestimated the size.
Two lessons for a website schedule. First, a "worst case" added to the plan is not enough, because plans describe how the project will go, not how projects like it have gone. Kahneman and Lovallo called these the inside view and the outside view. Second, you can take the outside view cheaply. Ask a studio for the actual start to launch times of its last five comparable projects, and which waits made the difference. Formal reference class forecasting needs a sizeable set of comparable past projects, so five is a sanity check, not a statistic.
The tail: between finished and live
A project can be finished and still not live. These items have lead times set by other organisations:
- Moving a domain between registrars. ICANN's Transfer Policy lets a registrar deny a transfer within 60 days of the domain's creation or of an earlier transfer. The registry completes a transfer unless the losing registrar objects within 5 calendar days, and a registrar without self-service has 5 calendar days to provide the authorisation code. After a change of registrant, a 60-day lock applies unless the owner opted out beforehand. If you will move the domain, start two weeks before launch, and not on a domain bought a month ago.
- DNS caching. A resolver can keep serving an old record until its TTL runs out. Lowering the TTL on launch day does not shorten entries already cached under the old, longer value, so lower it at least one old-TTL period ahead. A summary of Webflow's help centre says changes can take up to 48 hours to reach all locations, though usually a few hours, and that the certificate is issued only after DNS points to the platform.
- Search engines. For a medium site with new URLs, Google says it can take a few weeks or more for the new URLs to replace the old ones, and to expect temporary ranking fluctuation. Keep redirects at least a year, keep redirect chains to 3 hops or fewer and change one thing at a time. The redesign SEO checklist has the redirect map.
- After launch. Domain, certificate and form delivery checks belong in the first week. See the maintenance checklist.
Contract terms that protect the date
Agency terms we found in search vary, and no source states an industry standard. Common patterns: two or three feedback rounds in the scope, a stated turnaround such as 2 business days or 48 hours, deemed approval after 5 business days of silence, and a clause that client-caused delay moves the launch date. These are examples from agency terms and templates, not LAIN's, and not legal advice. What matters is that dates for feedback are written down at the start.
Where this goes wrong
- The date was set before the scope. Cause: a launch event or campaign fixed the end date. Fix: cut templates, not review time. Keep the pages that carry the offer.
- Feedback arrives in pieces. Cause: five reviewers send five lists. Each list restarts a round. Fix: one owner merges feedback and answers conflicts.
- Content arrives after the layout. Cause: copy is treated as a late task. Detect: placeholder text in the review. Fix: agree headlines, page names and button labels in the first phase.
- Late scope. Cause: a new integration or page type after design. Fix: freeze the template list at the end of the first phase and price changes as changes.
- Launch week surprises. Cause: domain lock, DNS TTL, a payment account awaiting verification. Fix: run the tail list above two weeks before launch.
What LAIN plans

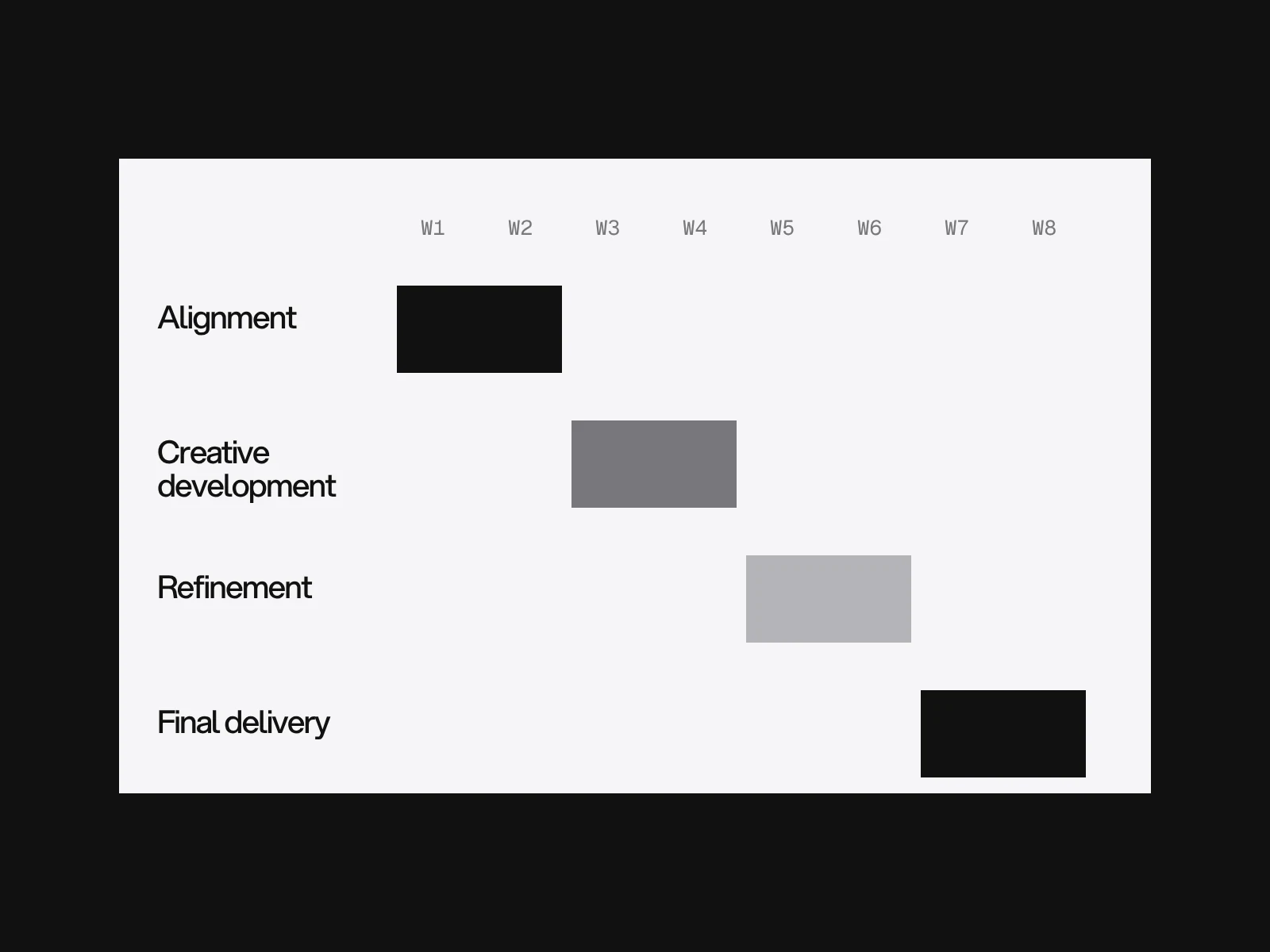

Every LAIN project follows four phases: Alignment (moodboard, questionnaire, research, goals), Creative development (concepts and page design), Refinement (iterations, your feedback, quality checks) and Final delivery (files, guidelines, handover and launch). For a website design and development project the range is 6 to 10 weeks, and we confirm it after reading your brief. Planned well, build can start on agreed pages while others are still being refined. Other services run on their own clocks: branding 4 to 6 weeks, app or dashboard design 8 to 12, graphic design 2 to 4, and social media is ongoing. When you are ready, send us a brief. We reply within a day.
Frequently asked questions
How long does it take to design a website?
A typical business website takes 6 to 10 weeks at LAIN, from the first conversation to launch. Other sources quote 4 to 12 weeks for small business sites and months for custom or e-commerce builds, mostly because they count different things. Ask where the clock starts and stops, and whether a page means a unique layout.
Why do agency website timelines vary so much?
They start and stop the clock at different points, count pages differently and assume different amounts of waiting. Shopify's own stage durations add up to 13 to 26 weeks if run back to back, while it also says a site can take one week to five months. The number of unique templates and integrations moves the schedule more than the number of pages.
Does review speed matter more than design speed?
In a simple model of 30 working days of studio effort and four review gates, cutting review turnaround from 4 days to 2 at two rounds per gate saves 16 working days. A studio working 20 percent faster saves 6. The model is illustrative, not a LAIN schedule, but it shows why dates for feedback matter.
How long does it take for a website to go live after approval?
Often a day or two, but it depends on domain and DNS. Webflow's help centre says DNS changes can take up to 48 hours to reach all locations, usually a few hours. Moving a domain between registrars can take 5 calendar days to approve and the code can take 5 days to arrive, and a domain registered or transferred in the last 60 days may be locked.
How many rounds of feedback should a website project include?
There is no standard. Agency terms we found cap rounds at two or three per deliverable, ask for feedback within 2 business days or 48 hours, and treat silence for about 5 business days as approval. Agree the number, the turnaround and who has the final say before design starts.
How long before rankings settle after a website redesign?
Google says that for a medium site with new URLs it can take a few weeks or more for the new URLs to replace the old ones, and that temporary fluctuation is normal. It advises keeping redirects for at least a year. Plan a monitoring period after launch rather than judging results in the first week.
Sources and fact check
Facts in this article that come from outside LAIN were checked on 28 Oct 2026 against:
- Buehler, Griffin and Ross: Exploring the planning fallacy, Journal of Personality and Social Psychology, 1994
- Shopify: How long does it take to build a website
- ICANN: Transfer Policy, 2024 version
- Google Search Central: Site move with URL changes
- Webflow Help: Troubleshoot your DNS settings
- InformIT: Principle 1, take an economic view (Reinertsen, Little's law and queues)
- W3C Internationalization: Text size in translation
- University of Oxford report on reference class forecasting (Edinburgh Tram Inquiry)
- Jonathan Nicol: A website can't be measured in pages
- Flyvbjerg: Quality control and due diligence in project management, taking the outside view
Timelines, services and process described here are LAIN's own, as set out on our About and FAQ pages.
